Clear to Build at Tennant Company

Machines built from thousands of parts, bills of material up to eight levels deep, and demand that keeps moving. After go live with SAP S4/HANA, Tennant needed to know which production orders can actually be build — and what was missing on the rest. Prototype in one week, live in one month.

Industrial cleaning equipment · founded 1870 · ~4,500 employees

  • Sector Industrial equipment manufacturing
  • The challenge Component availability: now, future and what-if
  • The solution Clear to Build (CTB)
  • Idea to production 3 months

Thousands of parts, one question

Tennant builds advanced cleaning machines, in standard configurations and to customer-specific requirements. Together with a constantly changing supply and demand situation, that raises a complex question on the factory floor: what do we need to build based on customer priority, and can we make it?

A Tennant T7AMR ride-on floor scrubber

A single machine can carry thousands of parts across a bill of material up to eight levels deep. Sub-assemblies are manufactured in one plant and shipped on to others for final assembly, and to warehouses for customer service and repairs — so availability changes every hour of the day. On top of that sit long component lead times, shifting market demand, tenders, and customer-specific configurations that change what a machine consists of.

Assembly capacity is limited, which makes the release decision the one that matters: only orders with high customer priority and no missing parts should reach the line. Everything else creates a shortage halfway through a build.

Answering that for one order means walking the structure, the stock and the incoming supply. Answering it for every open and planned order, and again tomorrow when demand has moved, is more than a planner's day contains. What Tennant needed was that answer standing ready — and, where the answer was no, the list of parts that were missing and the date they would arrive.

The scenario-based application provides us with the opportunity to optimize our production planning while maintaining the agility needed to support a dynamic business environment. The Accelerate2Value team has been incredibly responsive and collaborative, consistently listening to our requirements while providing valuable insights and recommendations that drive meaningful results.
Christine Jacobson
Senior Director Global Strategic Supply, Tennant Company

Clear to Build

Clear to Build is a planner's tool: it shows where things stand, and opens up the detail behind a shortage. It lets a decision to solve a shortage be tried before it is made.

Clear to Build calculates a status per order from current stock and expected supply. It shows whether stock is available and available for this particular order; whether the order could be built by taking stock from one of lower priority; and, where parts fall short, exactly which ones, when planned supply arrives and where it is coming from — all of it calculated on Tennant's own ERP data.

A planner can run different scenarios by committing production orders or uncommitting them, and Clear to Build shows the effects of each.

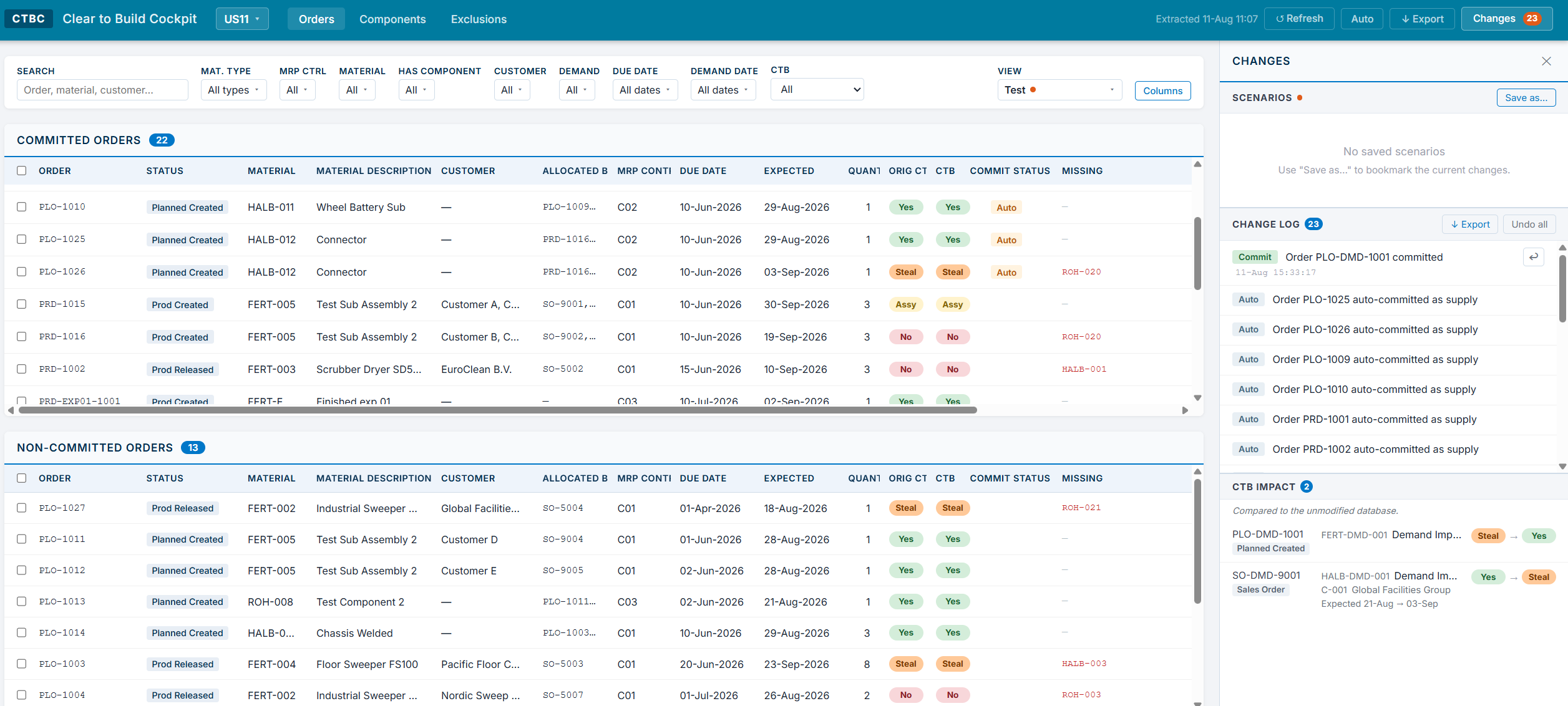

The Clear to Build overview — every released, unreleased and planned order with its status
The Clear to Build overview — every released, unreleased and planned order with its status
Richard and Nanne quickly bridged our reporting knowledge gap, providing expert guidance and collaborative working sessions that transformed our vision into a practical, user-friendly solution.
Nick D'Allura
Director of North America Materials, Tennant Company

Business value

Clear to Build increases productivity, both for the planner and for the factory. Fewer factory stops, better customer satisfaction.

From day one, planners got better insights into their production planning. That changes four things day to day:

  • Shortages surface on released and unreleased production orders, while there is still time to act on them
  • The effect of committing a planned order is visible before it is committed
  • Critical components for high-priority customers can be pushed to the front of the queue
  • Delays in incoming supply are tied to the shortages they cause, so the supplier conversation starts from facts

All if it based on Tennant's own ERP data.

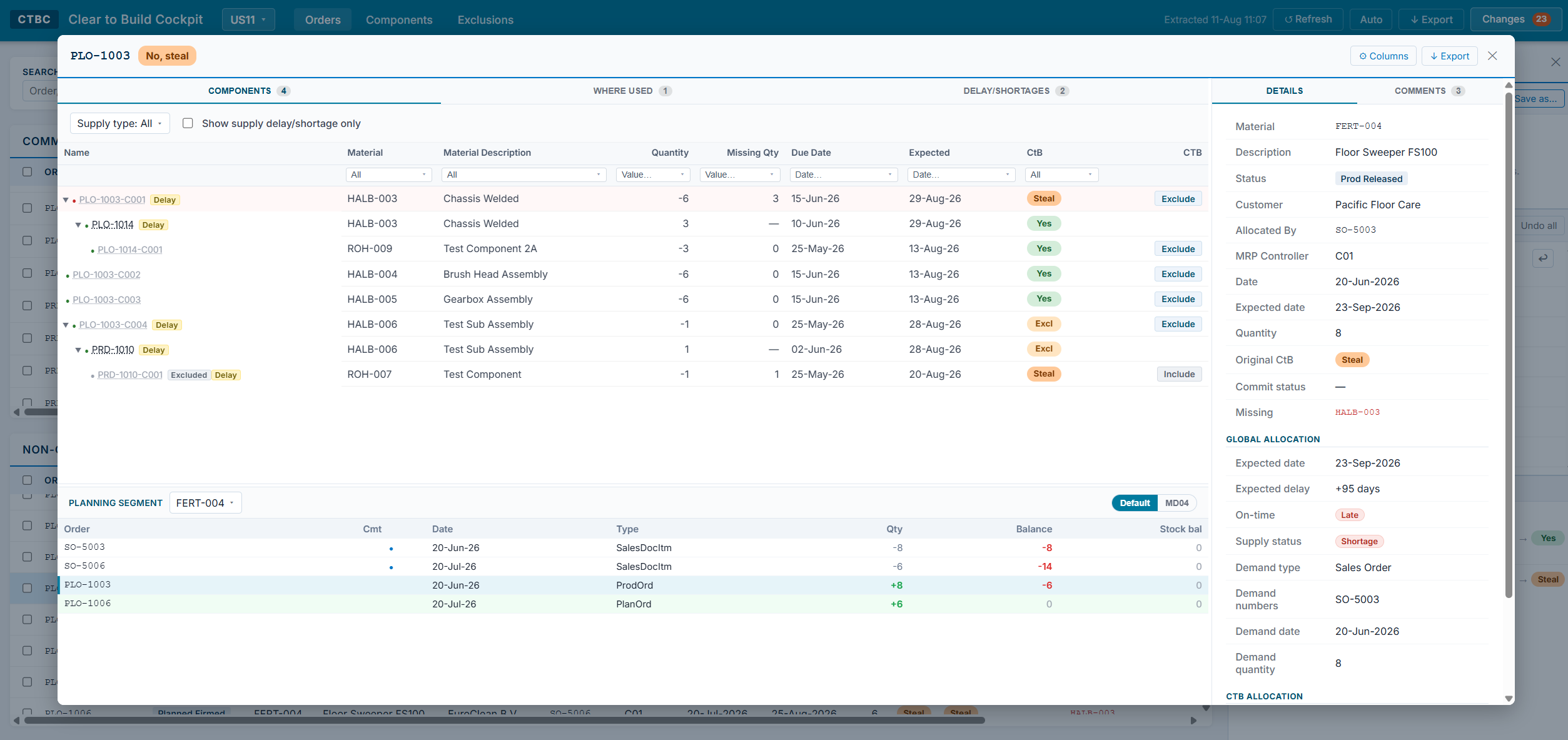

Missing-part analysis — component, demand and the status of the supply that will cover it
Missing-part analysis — component, demand and the status of the supply that will cover it
I am very fond of the CTB tool. Whether I'm doing simple part-by-part planning or pulling data for reporting purposes, the CTB has a means to easily extract the data. Having that planning data easily accessible has shaved hours off my weekly planning.
Anne Tudor
Senior Planner, Tennant Company

The project: Three months, four milestones

No specification phase and no big-bang release — a prototype to prove the idea, then working software every week.

  1. May 2026

    Challenge and prototype

    Tennant explained the challenge; a working prototype on their own data followed within a week. The project started with one objective: live in July.

  2. June 2026

    Implementation

    Weekly sprints, cloud deployment, testing and first trial usage — with user feedback landing as improvements in the next sprint.

  3. July 2026

    Go-live

    Version 1.0 live for a first group of users, on the objective set two months earlier.

  4. August 2026

    Rollout

    Rollout to the wider user community, with improvements continuing alongside it.

Deployment and integration

On the IT side the project stayed straightforward: no new platform to adopt, no data leaving Tennant's environment, and a standard integration with SAP S/4HANA.

Clear to Build was deployed into Tennant's own cloud environment, inside their tenant and under their identity and access management. That happened during the project rather than after it — the first version users tried was already running where the productive version would run, so go-live was a matter of opening it up to more people rather than moving it anywhere.

The integration with SAP S/4HANA was equally straightforward. Clear to Build reads what it needs — material master data, bills of material, stock, production and planned orders, and incoming supply — and calculates on top of that. It writes nothing back: S/4HANA stays the single source of truth, and the tool stays a lens on it.

From an IT project, deployment, and security perspective, working with Richard and his team was a truly positive experience. They delivered a high-quality solution in a remarkably short timeframe while working within Tennant's existing cloud, security, and SAP landscape. Their collaborative approach, technical expertise, and focus on business outcomes made the implementation seamless and low-risk. The result was not only a successful deployment, but also a strong partnership built on trust, responsiveness, and shared commitment to success.
Christina Agar
Senior IT Business Relationship Manager, Tennant Company

About the two companies

Tennant Company

Cleaning equipment for industrial and commercial use — scrubbers, sweepers, ride-on, walk-behind and robotic machines, plus the parts and service that keep them running.

  • Founded in 1870, headquartered in Eden Prairie, Minnesota (NYSE: TNC)
  • ~4,500 employees and USD 1.29 billion in net sales (2024)
  • 11 manufacturing locations, including the EMEA factory in Uden, the Netherlands
  • Direct sales in ~21 countries, distributors in more than 100
tennantco.com

Accelerate2Value

Customer-specific applications for the business-critical processes standard software does not cover — starting from the process rather than the technology.

  • 50+ years of combined software and business process experience
  • Weeks, not years — a prototype first, then working software each sprint
  • One team, from problem analysis through to support
  • Delivered as a managed service, on your existing ERP data
